NASHVILLE AREA METROPOLITAN PLANNING ORGANIZATION |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
Transportation Improvement Program for FYs 2011-2015 |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
Project Name |
|
|
Gateway Boulevard |
|
TIP # |
|
2006-124 |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
Improvement Type |
Road Widening |
|
Lead Agency |
|
Metro Nashville |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
County |
|
|
Davidson County |
|
Length |
|
0.20 |
|
Regional Plan ID |
1011-182 |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
Air Quality Status |
Non-Exempt |
|
TDOT PIN |
|
|
|
Project Cost |
|
$47,000,000.00 |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
Route |
|
Gateway Boulevard |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|

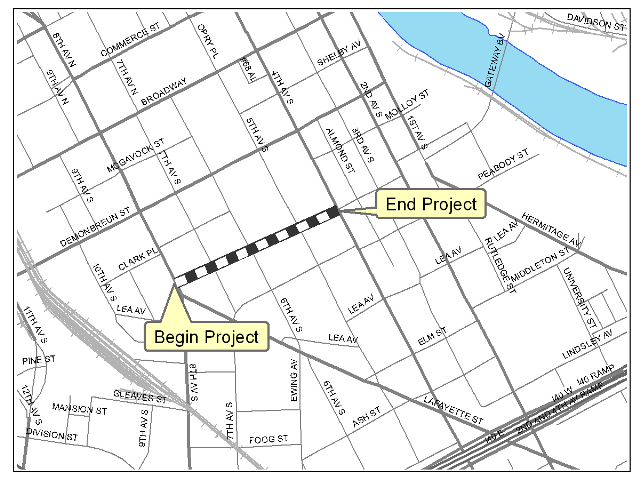

Location |
|
4th Ave to 8th Ave |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
Project Description |
|
Widen and construct from 2 to 6 lanes as urban boulevard with center median, sidewalks, and bike route with new intersection at 8th Avenue S and Lafayette Street. |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
Fiscal Year |
Type of Work |
Funding Type |
Total Funds |
Federal Funds |
State Funds |
Local funds |
|
2011 |
ROW |
U-STP |
$7,117,725.00 |
$5,694,180.00 |
$0.00 |
$1,423,545.00 |
|
2011 |
CONSTRUCTION |
U-STP |
$32,406,250.00 |
$25,925,000.00 |
$0.00 |
$6,481,250.00 |
|
2011 |
PE-D |
U-STP |
$233,750.00 |
$187,000.00 |
$0.00 |
$46,750.00 |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
REVISION HISTORY |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
4/25/2011 |
Amend# 2011-002 |
Add previous phase (PE) and shift $112,000 (federal) in U-STP funds from ROW to PE to finalize design changes associated with ROW acquisition completion |
|
|
|
|
|
5/21/2013 |
Amend# 2013-027 |
Project modified to shift $75,000 (federal share) from CONST to PE for design modifications during construction and PE phase close-out. The total project cost remained the same. |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
PROJECT NOTES |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
Nashville Area Metropolitan Planning Organization |
|
|
Transportation Improvement Program for FYs 2011-2015 |
|
