NASHVILLE AREA METROPOLITAN PLANNING ORGANIZATION
Transportation Improvement Program for FYs 2014-2017
Project Name Concord Road (SR-253) Widening TIP # 2006-013
Improvement Type Road Widening Lead Agency Brentwood
County Williamson County Length 0.80 Regional Plan ID 1062-159
Air Quality Status Non-Exempt TDOT PIN 106994.00 Project Cost $5,290,000.00
Route Concord Road (SR-253)

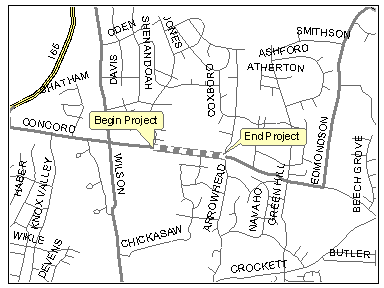

Location Jones Parkway east to Arrowhead Drive
Project Description This project provides for improvements to a substandard section of Concord Road between Jones
Parkway and Arrowhead Drive.  Included is a 3 lane, curb and gutter road section with paved shoulders, a
separated multi-use path on the south side from Arrowhead Drive to Wilson Pike, a sidewalk on the north
side between Arrowhead Drive and Jones Parkway and the relocation of affected utilities.
Fiscal Year Type of Work Funding Type Total Funds Federal Funds State Funds Local funds
2014 CONSTRUCTION U-STP $5,073,980.00 $2,840,000.00 $0.00 $2,233,980.00
REVISION HISTORY
PROJECT NOTES
3/15/16 - The City has obligated funds remaining in the ROW
phase of this project that they do not anticipate billing for. They
have requested via formal letter to the TDOT Local Programs
Development Office that $757,718.37 (federal) of that
remaining balance be transferred to the construction phase,
which has also been obligated at this time. $10,000 (federal)
will remain in ROW for any incidentals. Please see "Project
Documents" for a copy of the letter sent to TDOT.
12/17/12 - This is a locally managed continuation project
requesting additional construction funds to complete the
project.  The City has provided 100% local funding for
engineering and design as well as ROW acquisition.  As noted
above, the project has completed the PE-Design and PE-
NEPA phases and is nearing completion of the ROW phase.
An environmental document has been prepared and approved
in accordance with 23 CFR 771 and National Environmental
Policy Act of 1969 regulations. It is projected that the currently
programmed $3.4 million in U-STP funds will be obligated in
FY 13 with construction also commencing in FY 13 and taking
approximately 1 year to complete.
Nashville Area Metropolitan Planning Organization Transportation Improvement Program for FYs 2014-2017
