NASHVILLE AREA METROPOLITAN PLANNING ORGANIZATION |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
Transportation Improvement Program for FYs 2014-2017 |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
Project Name |
|
|
MTA - Administration Building Rehabilitation (Nestor) |
|
TIP # |
|
2008-15-049 |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
Improvement Type |
Transit Capital |
|
Lead Agency |
|
Nashville MTA |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
County |
|
|
Davidson County |
|
Length |
|
0.00 |
|
Regional Plan ID |
1015-313 |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
Air Quality Status |
Exempt |
|
TDOT PIN |
|
|
|
Project Cost |
|
$4,620,000.00 |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
Route |
|
MTA - Administration Building Rehabilitation (Nestor) |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|

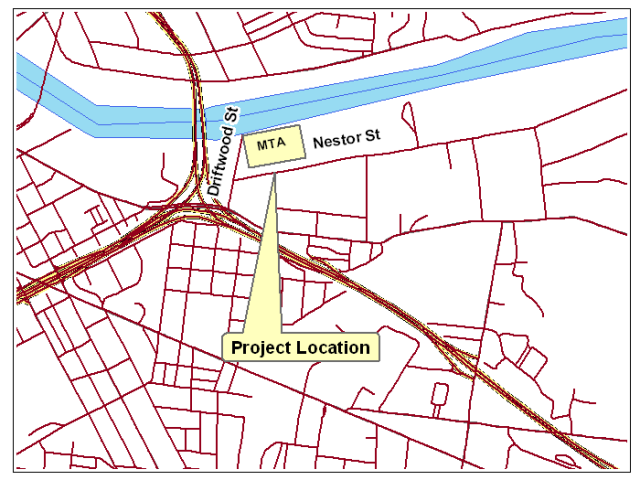

Location |
|
130 Nestor Street, Nashville. |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
Project Description |
|
Rehab/renovate administration and maintenance facilities, additional office space. |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
Fiscal Year |
Type of Work |
Funding Type |
Total Funds |
Federal Funds |
State Funds |
Local funds |
|
2014 |
CONSTRUCTION |
FTA 5307 |
$625,000.00 |
$500,000.00 |
$62,500.00 |
$62,500.00 |
|
2015 |
CONSTRUCTION |
FTA 5307 |
$3,995,000.00 |
$3,196,000.00 |
$399,500.00 |
$399,500.00 |
|
2017 |
IMPLEMENTATION |
FTA 5307 |
$0.00 |
$0.00 |
$0.00 |
$0.00 |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
REVISION HISTORY |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
9/14/2015 |
Amend# 2015-028 |
This project has been amended to advance the project schedule and add $3,196,000 (federal) in FYs 2014 and 2015 FTA 5307 funds shifted to the project from TIP# 2008-17-021. Projected FY 2017 funding amounts have been dropped from the project. |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
PROJECT NOTES |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
1/3/13 -Milestone 1 – Final Design and Construction Plans 60 days from grant award.Milestone 2 – Project Out for Bid 75 days from grant award.Milestone 3 – Contract Awarded 90 days from grant award.Milestone 4 – Begin Construction 120 days from grant award.Milestone 5 – Complete Construction 365 days from grant award. |
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
Nashville Area Metropolitan Planning Organization |
|
|
Transportation Improvement Program for FYs 2014-2017 |
|
Printed on |
Sunday, December 22, 2024 |
|
|
|
|
|
|
|
|
